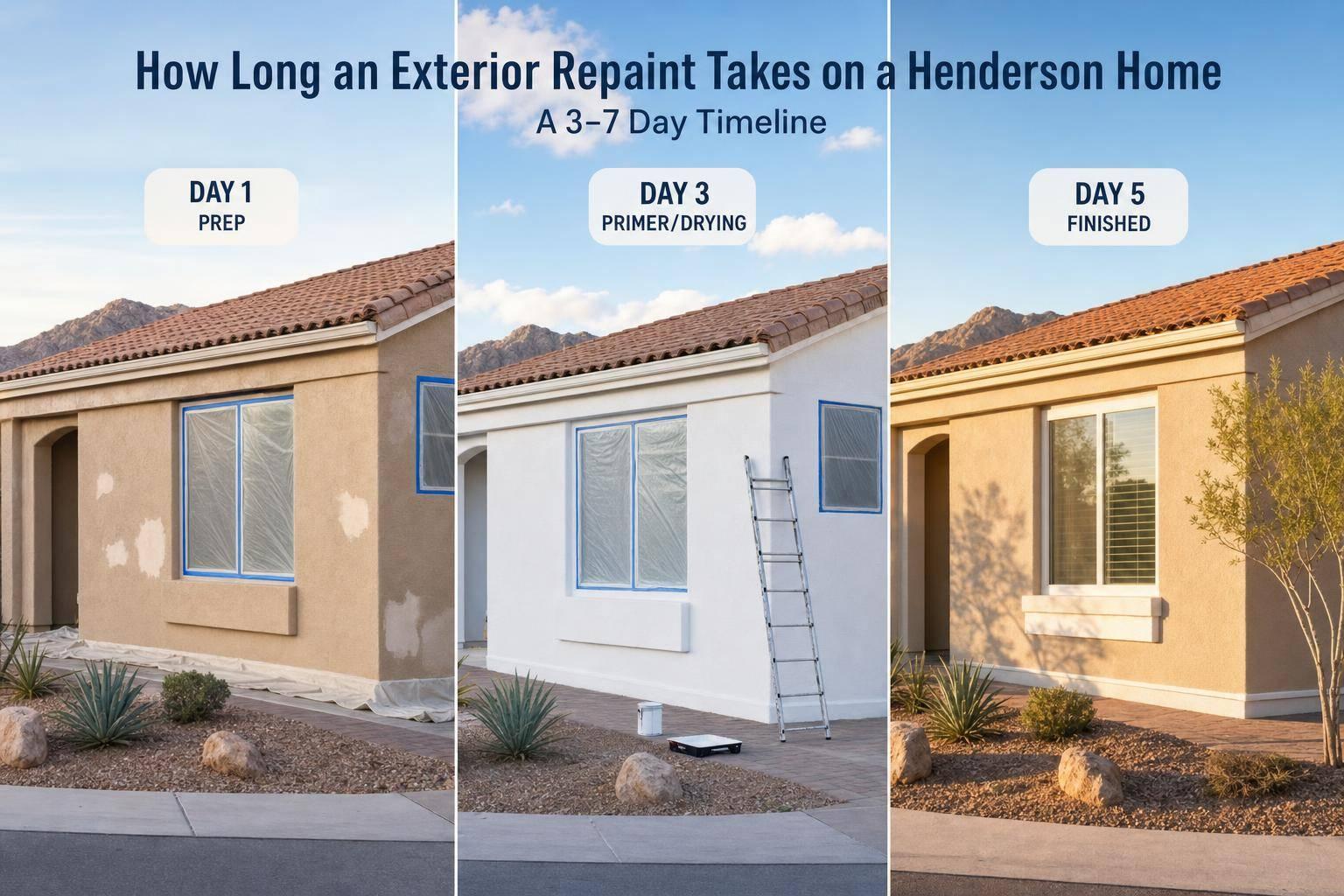

Home Improvement September 25, 2026

How Long an Exterior Repaint Takes on a Henderson Home

Most Henderson exterior repaints take 3–7 working days; prep, drying, repairs, and weather shape the schedule.

How Long an Exterior Repaint Takes on a Henderson Home

How Long an Exterior Repaint Takes on a Henderson Home

Most Henderson exterior repaints take 3 to 7 working days. If I had to give you the short answer, that’s it.

Here’s what that time usually includes:

  • Day 1: Washing, masking, scraping, sanding, and small repairs
  • Day 2: Drying time after washing, plus caulk and patch work
  • Days 3–5: Primer and two finish coats
  • Days 5–7: Trim, doors, fascia, touch-ups, cleanup, and final walkthrough

A few things can push the job closer to the long end:

  • Two-story homes
  • Peeling or failed paint
  • Stucco cracks or wood repairs
  • Big color changes
  • Rain, wind, dew, or very high heat

A few things can keep it closer to the short end:

  • Single-story layout
  • Sound existing paint
  • Minor prep
  • Dry weather
  • Simple trim and fewer detail areas

One point matters most: I’d plan by working days, not calendar days. Washing can need 24 hours or more to dry. Paint may feel dry fast, but recoat time is different. And after rain, crews may need 1 to 2 extra days before painting starts again.

If you want a tighter timeline, I’d have these details ready before asking for an estimate:

  • Home size and number of stories
  • Stucco, wood, or other exterior material
  • Any peeling paint, chalking, cracks, or rot
  • Whether trim, doors, gates, and railings are included
  • HOA approval status

This gives you the full picture upfront: most jobs take less than a week, but prep, drying, and weather often take as much time as the painting itself.

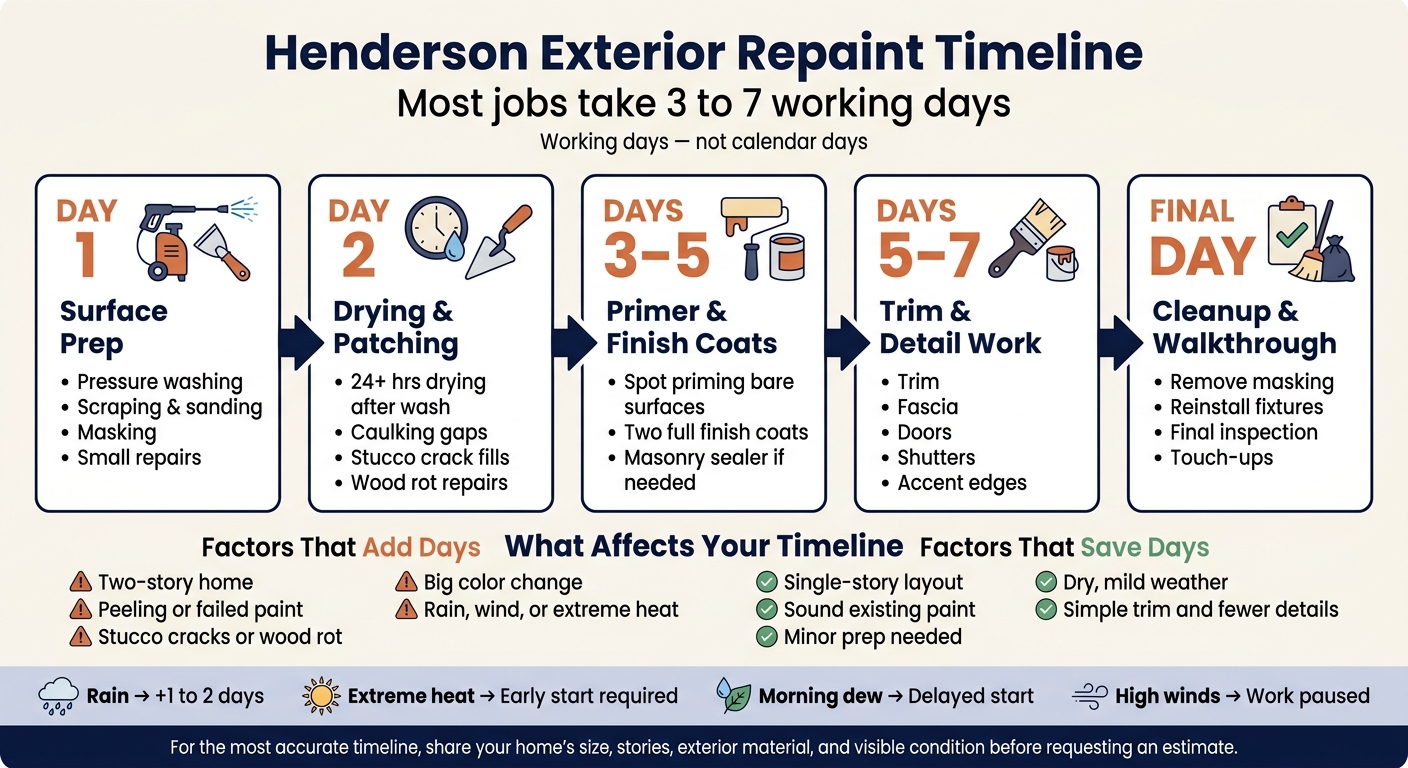

Henderson Exterior Repaint Timeline: Day-by-Day Breakdown

Henderson Exterior Repaint Timeline: Day-by-Day Breakdown

Preparation and Drying Take Up the First Part of the Project

Prep is a big reason the timeline runs longer than the painting itself. Before any coating goes on, the surface has to be cleaned, fixed, protected, and given time to dry all the way.

Cleaning, scraping, sanding, and caulking before paint goes on

The work usually starts with pressure washing to clear off dirt and the chalky residue that builds up on sun-exposed stucco. After that, the crew scrapes away any loose or peeling paint and sands rough or glossy spots so the new coating sticks the way it should.

From there, they move into repairs. That can include filling small stucco cracks, caulking gaps, and patching damaged areas. Minor wood-rot fixes on trim or window frames are often handled during this stage too. The crew also masks landscaping, windows, lights, and concrete with plastic and tape to block overspray.

Why washed surfaces may need a day or more to dry

Once the washing is done, the waiting starts. Surfaces often need a day or more before priming or painting begins. Shaded walls and porous stucco tend to hold moisture longer, which means one side of the house can dry more slowly than the other.

Turn off automatic sprinklers 24 hours before work starts and keep them off for 24 hours after the final coat. Ask for moisture checks on stucco and wood before priming.

After the surface is fully dry, primer and finish coats can begin.

Primer, Finish Coats, and Detail Work Add More Working Days

Once the surface is dry, the job moves into primer, finish coats, and the small detail work that tends to eat up extra time.

When primer is needed and how extra coats add time

Primer comes next, but only where it’s needed. Not every wall needs a full coat. Still, bare wood, stained spots, and areas where failing paint was scraped or sanded down to the substrate should be spot-primed. Primer also matters on repaired stucco or wood because it helps the new paint stick the way it should. Skip it, and the finish coat can look uneven or start peeling later.

Repaired stucco may also need a masonry sealer before the finish coats go on. And if the house has a big color shift or a lot of weather wear, expect another coat to get solid coverage.

Dry to the touch, ready to recoat, and fully cured are not the same thing

These terms sound similar, but they mean very different things. Paint may feel dry fast in hot weather, but that doesn’t mean it’s ready for the next coat. Recoat timing comes from the product label, and it changes based on temperature and airflow. If the next coat goes on too early, moisture can get trapped under the surface and cause bubbling.

Fully cured is a separate milestone. That’s the point when the paint reaches its maximum hardness, and it can take much longer after the final coat.

Stage-by-stage timeline table

The table below shows the usual order of work and the kinds of issues that can slow each step down.

Project Stage Work Performed Factors That May Extend Stage
Repairs Caulking gaps, filling stucco cracks, and wood or trim repair. Large-scale wood rot or deep structural stucco cracks.
Priming Spot-priming bare wood or stucco, or applying masonry sealer to chalky areas. High number of repaired areas or major color changes.
Finish Coats Applying two finish coats on the main walls. Extra coats for coverage or working around high heat and wind.
Detailing Painting trim, fascia, shutters, and doors, plus fine-tuning edges. Complex architectural features or multiple accent colors.
Cleanup and walk-through Reinstalling fixtures, site cleanup, and a final customer walk-through. Discovery of missed spots or extra touch-up requests.

How Henderson Weather Can Change the Painting Schedule

Henderson weather can add time to an exterior repaint. Rain, morning moisture, heat, and wind can slow the job down and affect how well paint sticks. That's why a repaint that usually takes 3 to 7 days can stretch by a day or more.

Rain, damp surfaces, and checking the forecast before work starts

Even a short rain shower can stop an exterior repaint. Once rain hits, the surface needs to dry out fully before anyone applies primer or paint.

Heat, shade, and manufacturer temperature limits

Henderson summers get HOT, and direct sun can make paint dry too fast. When that happens, you can end up with flashing, which means the finish looks uneven or patchy. To avoid that, crews often start early and paint the shaded sides of the home first so the coating goes on more evenly.

Shade helps with heat, but it can also slow things down. Surfaces that stay shaded may hold onto morning dew or overnight moisture longer than you expect. Metal parts like railings and gates can need extra drying time before priming too.

It's also smart to follow the coating label closely, especially for temperature limits and recoat times. If paint goes on outside the listed range, curing can slow down and the finish may not hold up as well. Wind can create trouble too. Strong gusts may blow dust onto damp paint, which can hurt adhesion.

The chart below shows how each weather condition can shift the schedule.

Condition Effect on the Project Typical Adjustment
Rain or wet surfaces Prevents adhesion and can wash away uncured paint Wait until surfaces fully dry; add 1 to 2 days after rain
Extreme heat / direct sun Can cause flashing and uneven drying Start early and work in shaded sections
Morning dew / overnight moisture Delays the start and can affect metal surfaces Wait for surfaces to dry before priming
High winds Blows dust onto damp paint, reducing adhesion Pause work and clean surfaces before resuming

Final Inspection and Setting a Realistic Schedule

What gets checked before the project is done

After weather delays and coating time, the last step is the final walkthrough. Before the crew leaves, they check for even color, missed spots, drips, clean trim lines, and tight caulk joints around windows, doors, and other openings.

They also remove masking tape, plastic, and other protective materials. Then they put light fixtures, house numbers, and any other items that were taken down back in place. This closeout phase usually takes less than a day.

The final walkthrough wraps up the job. But getting the schedule right starts much earlier, with the details of your home.

Details to have ready before asking for a timeline

If you want a tighter timeline estimate, share the right details upfront. A painter can give you a much better sense of timing when they know what they're working with.

Detail Why It Matters
Square footage and stories Larger or taller homes take more time to prep and coat
Exterior material (stucco, wood siding, etc.) Different surfaces need different prep and dry times
Visible condition Peeling paint, chalky stucco, or dry rot on trim all add prep time
Areas included Fascia, eaves, garage doors, gates, and railings each add working time
HOA approval Waiting on HOA sign-off can delay the start date

With an on-site assessment, homeowners get the most accurate schedule for their Henderson home. Most exterior repaints on Henderson homes take 3 to 7 working days from prep through final walkthrough, depending on repairs and weather.

FAQs

Can I stay home during the repaint?

Yes. You can stay home during the repaint. Victory Painting works fast and keeps disruption to your daily routine to a minimum.

For exterior work, keep pets indoors during work hours and move vehicles so the crew has clear access to your home.

What should I do before the crew arrives?

Before Victory Painting arrives, check that any HOA color approvals are in place to help avoid delays.

Also, please:

  • Move vehicles away from the work area
  • Keep entry points and the garage clear
  • Keep pets indoors during work hours
  • Turn off sprinklers near the house for 24 hours before and after painting so surfaces stay dry for proper paint adhesion

How long should I wait before turning sprinklers back on?

Keep sprinklers off near the house for 24 hours before and after painting. That gives the surface time to stay dry, which helps the paint go on properly and cure the way it should.

It’s also smart to adjust your sprinkler heads so they don’t spray stucco or wood siding.

Ready to start your project?

Contact us today for a free consultation.

Get in Touch

Free estimates

Ready to refresh your home?

Tell Victory Painting what you need and Vic will follow up with a free, no pressure estimate. Serving Henderson, Las Vegas, and the surrounding valley since 1993.
